Planning a five-month South Pacific sailing season requires more than choosing a departure date and plotting a few destinations. Weather windows, cyclone seasons, crew, provisioning, maintenance, insurance, customs, communications and yacht reliability all need to work together.
Our preparation began well before departure. We used a long-term plan to progressively prepare the yacht, train the crew, test major systems and build the documentation needed for international cruising. By departure, the objective was simple: spend less time solving preventable problems and more time sailing.
This article is broken into 4 PARTS. It explains how we approached the overall five-month plan, throughout the South Pacific, and how the major decisions fitted together.
Our biggest advantage was time. We broke the preparation into manageable annual goals rather than trying to complete everything immediately.
Over three years, we completed major upgrades, maintenance and system improvements while still using the yacht. This gave us the opportunity to test equipment in real conditions and identify problems before committing to extended offshore passages.
During this period, we also completed two separate five-month Coral Sea voyages.
The plan was divided into four stages:
Year 1: Core mechanical, electrical and power systems
Year 2: Sailing systems, water production and onboard infrastructure
Year 3: Navigation, communications, safety equipment and final refit
Six months out: Maintenance packs, spares, crew preparation and offshore readiness
This approach also made insurance requirements, training and documentation easier to manage because each major task was completed and recorded progressively.
Good documentation became one of the most useful parts of our preparation. We started building records early and continued updating them throughout the refit.
The aim was simple: create a central reference for:
> Yacht systems,
> Maintenance procedures,
> Emergency information, and
> Equipment locations.
Instructions were written so another crew member could follow them without needing the captain standing beside them. Procedures included tasks such as changing a propeller, locating circuit breakers and replacing batteries.
Offshore, the key question was:
If you were injured or unable to assist, could your crew safely operate the yacht?
Our answer was to develop a detailed onboard CREW MANUAL, supported by a CREW DECLARATION covering responsibilities, training and operational requirements.
Food storage and electrical planning are closely connected.
We divided provisions into four categories:
> Frozen food
> Refrigerated food
> Dry goods
> Fresh produce
Battery capacity needed to support refrigeration and freezer loads continuously, with a 30% reserve. Hot tropical conditions and frequent access to the fridge can significantly increase energy consumption.
We also used an external esky for drinks and water, reducing unnecessary access to the main refrigerator.
Consider what happens if refrigeration fails. Long passages and remote anchorages leave little opportunity to replace spoiled food or repair equipment quickly.
We discuss in more detail in Part 2 about our OFFSHORE PROVISIONING, and provide a downloadable document of our OFFSHORE PROVISIONING LIST.
Major systems were installed early enough to be tested over time. This allowed us to learn how each system behaved, identify weak points and develop practical backup procedures.
A structured maintenance schedule then kept servicing and consumable replacement on track.
The first year concentrated on major electrical and mechanical upgrades, including lithium batteries, Isotherm freezer and fridge, 1.9 kW solar, new saildrives, new inverter/charger, and upgraded 12 V DC systems and panels.
The second year focused on sailing equipment, weather protection and water systems: square-top mainsail, genoa and screecher, canvas covers and clears, new watermaker, electronic water pressure controller, water tank locker modifications.
The final major refit year concentrated on navigation, propulsion and structural maintenance: Raymarine multifunction display, doppler radar and anemometer, Gori propellers, antifouling, new skin fittings, ew cockpit cushions, mast stepping, and yacht survey.
By the later stages of the preparation, we began turning individual maintenance jobs into pre-prepared Service Packs.
Each pack contained the required consumables, spare parts, disposable gloves, relevant tools and a simple checklist. Contents were sealed in zip-lock bags to protect them from moisture and corrosion.
Examples included:
> Engine service pack
> Watermaker service pack
> Bilge pump pack
> Propeller pack
> Life jacket pack
> Transfer pump pack
The objective was to avoid searching through storage lockers for individual parts when a service or repair was required offshore.
Insurance should be considered well before departure, particularly when international waters are involved.
Our planning covered four areas:
> Local-water yacht insurance
> International-water yacht insurance
> Personal medical insurance
> Offshore medical and evacuation cover
Standard health insurance may contain exclusions relating to injuries sustained aboard private vessels in international waters, while medical evacuation can also be excluded.
These conditions need to be checked against your actual cruising plans rather than assumed.
Offshore passages depend on critical systems that must remain reliable when assistance is unavailable. Fresh water, electricity, communications, and food storage each require equipment that is tested and reliable, well-designed, properly maintained, and supported by a practical backup.
Fresh water is a critical offshore resource. Your tanks, watermaker, pumps and filtration systems need to operate reliably throughout the passage. Tank water should be split and at least one tank isolated. This tank becomes the reserve for equipment failure or an extended period without water production. The remaining tank should carry sufficient water for drinking, cooking and hygiene.
Reliable electricity supports navigation, refrigeration, communications, lighting, autopilot and essential onboard equipment.
A well-designed offshore electrical system needs adequate generation, battery capacity, monitoring and redundancy. Solar generation, lithium batteries and efficient power management can reduce dependence on engines and protect essential systems during long passages.
Offshore communications provide weather information, emergency contact and access to assistance when required. Maintain independent communication methods such as VHF, satellite communications and other suitable systems.
Test equipment before departure and ensure the crew understand how to use each system during normal operations and emergencies.
We have already discussed.

The most important part was not any individual upgrade. It was having a structured plan and progressively turning that plan into a documented, tested and maintainable cruising yacht.
I leave you with a note on Offshore Charting.
What drives someone to take on the enormous challenge of offshore cruising? It’s far from ordinary life. For some, it’s the pull of the unknown. For others, it’s the desire to test themselves against nature, uncertainty, and the open ocean.
Whatever the motivation, reaching the point of true offshore readiness rarely happens overnight. For us, it took two full years of steady preparation, careful planning, and incremental progress before we felt genuinely ready to depart.
Was the yacht prepared for offshore sailing?
We believed it was. Months spent in remote anchorages and isolated cruising grounds revealed weaknesses. Every haul-out became another opportunity to improve systems, solve problems, and refine the boat for long-distance passage-making.
Over time, you begin to understand every sound and movement of the yacht — every squeak, vibration, and shudder. With each offshore passage, confidence in both the vessel and your preparation grows stronger.
Of course, offshore cruising also delivers moments that instantly sharpen your focus: close encounters with reefs, unexpectedly shallow water, or submerged rocks sitting only centimetres beneath the keel.
Experiences like these remind you that preparation, seamanship, and situational awareness are everything.
Until you’ve navigated your most valuable asset through conditions like this, it’s difficult to fully appreciate the intensity and responsibility of offshore sailing.
We talk about this a little more shortly; however, what do you do with a medical emergency, such as a burn occurs? What does your medical training tell you to do?
THIS IS REAL...ask us. It happened to us. We were flown internationally to treatment and have a skin graft to prove it. Does your Insurance help...offshore?
The reality is simple: preparing a yacht for offshore cruising is not a weekend project. It can easily take 24 months of upgrades, maintenance, testing, and experience-building to get prepared.
Add time to your offshore cruising TO DO list.
It wasn’t until we were truly offshore that we understood what real 2-metre and 3-metre ocean swells actually felt like. Coastal sailing and offshore passage-making are completely different experiences, and the learning curve becomes very real the moment land disappears behind you.
We also quickly realised how much we still had to learn.
Joining our first offshore rally became the fastest way to accelerate our knowledge and understanding of blue water cruising. It provided a safer environment to gain experience, learn critical offshore sailing lessons, understand the seriousness of ocean passages, and discover the level of planning required for this kind of adventure.
Then the questions start coming.
What medications are legal to carry between countries? Are you prepared to administer injections or emergency medical treatment at sea? Why should freshwater tanks be divided with isolation valves? What exactly is the purpose of a yellow quarantine flag?
Suddenly, offshore cruising introduces an entirely new language and skillset.
O.N. registration. Jacklines. Joker valves. PLBs. Redundancy systems. Spare parts inventories large enough to resemble a small marine chandlery.
And then comes the paperwork.
Authorities request EDN and IDN forms, crew lists, crew declarations, one-way travel documents, vessel registration paperwork, ship’s stamps, electronic equipment serial numbers, insurance details, and endless compliance requirements that vary from country to country. We made a Crew Manual that brings all this together.
The deeper you get into offshore cruising, the more you realise that successful long-distance sailing depends on three things above all else: preparation, redundancy, and self-reliance.
For many cruisers, this stage alone can take between 6 and 18 months to organise properly, especially when it comes to offshore sailing training, certifications, medical preparation, vessel documentation, and international clearance requirements.
Add these questions to your offshore cruising TO DO list.
“We’ve bought the dream boat. It just needs a little TLC, then we can make those dreams come true.” That’s how many offshore cruising adventures begin.
The reality, however, is that offshore and remote-area cruising demands a completely different level of preparation, redundancy, and self-sufficiency than most new owners initially expect.
We deliberately purchased a yacht with proven offshore pedigree, a vessel that had already completed extensive single-handed voyages throughout the Pacific. That history gave us confidence in the boat’s capability and seaworthiness.
But it didn’t take long to uncover the gaps between perception and reality.
The gas system, despite previous assurances, turned out to be non-compliant. The life jackets looked like relics from another era, outdated, deteriorated, and nowhere near current offshore safety standards.
Then came the offshore medical kit.
For anyone without a medical background, opening that kit can be a confronting experience. You suddenly realise that once offshore, you may be responsible for handling serious injuries and medical emergencies hundreds of miles from professional help.
The mechanical inspections told a similar story.
During a routine oil inspection, we discovered metal fragments in one of the sail-drives (2018), despite receiving documentation from the broker stating it had been professionally rebuilt and installed only months earlier in Fiji.
Offshore cruising teaches an important lesson very quickly:
Trust is valuable, but verification is essential.
Every system onboard must be checked, tested, serviced, and understood personally before committing to serious offshore passages.
For many cruisers, the purchase and refit phase alone can take 24 to 36 months to properly sort out, especially when addressing safety compliance, mechanical reliability, offshore medical preparedness, electrical systems, documentation, and long-term cruising upgrades.
Add these tips to your offshore cruising TO-DO list.
An electrician once asked me:
“Why are you installing a second autopilot? They’re incredibly reliable. I’ll do it...it’s your money, not mine!”
Interestingly, despite more than 40 years of marine electrical experience, the electrician also pointed out something many sailors overlook: 'The cabling itself rarely requires full replacement after an electrical fault event.'
Often single-handing more than 50% of the time (and/or sailing with low self-confidence), the answer was simple:
Redundancy offshore is not optional.
At sea, critical system failures are never just theoretical possibilities. I’ve personally witnessed a lightning strike completely destroy a yacht’s electronics, instantly disabling multiple onboard systems.
In many real-world lightning strike incidents, including well-documented cases aboard vessels such as Parlay Revival, it is typically the electronic components that fail, while much of the wiring infrastructure survives.
That reality heavily influenced our offshore autopilot redundancy strategy.
In practice, two permanently installed autopilot systems sharing the same onboard electrical environment could easily both be destroyed by a single lightning strike. Rather than relying on fully duplicated fixed installations, we prefer a modular, component-based replacement strategy that is both more resilient and significantly more cost-effective.
Instead of carrying two complete autopilot systems, we store critical spare components inside a Faraday bag. This allows us to rapidly replace failed autopilot electronics at sea while also simplifying offshore troubleshooting, repairs, and long-distance maintenance.
For serious offshore sailing, especially for solo sailors, practical redundancy is not simply about carrying duplicate equipment. It’s about survivability, repairability, and maintaining steering control when critical systems inevitably fail offshore.
Rather than carrying excessive spare wiring, we keep only enough backup cabling onboard to rebuild a basic but fully functional autopilot system if required.
Our offshore experience has repeatedly shown that maintaining reliable steering capability can rapidly become mission critical, particularly during heavy weather, long passages, or extended periods of solo watch-keeping.

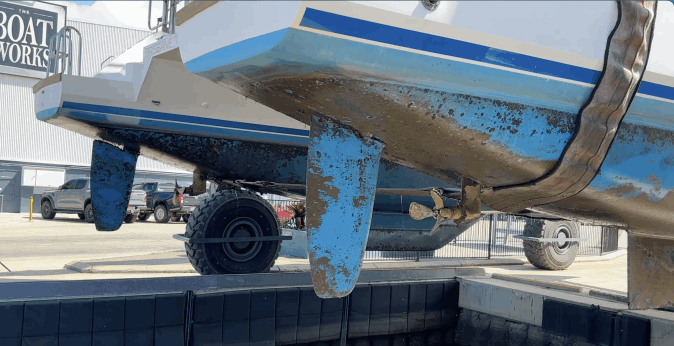

This also takes 6 months to sort out, in particular the possible Haulout. Get your Marine Survey done at the same time (for Insurance, they will ask).
Add Haulout and Autopilot to your TO DO LIST for Offshore Cruising.
